Lenovo cut the ribbon on its expanded Whitsett, North Carolina manufacturing campus on July 24, 2026 — a $77 million bet on closing the gap between accelerating customer demand and a global supply chain that has repeatedly buckled under it. The facility now spans 890,000 square feet, double its previous footprint, and draws 20 MW continuous power from Duke Energy. The conversion from empty warehouse to running production line took nine months.

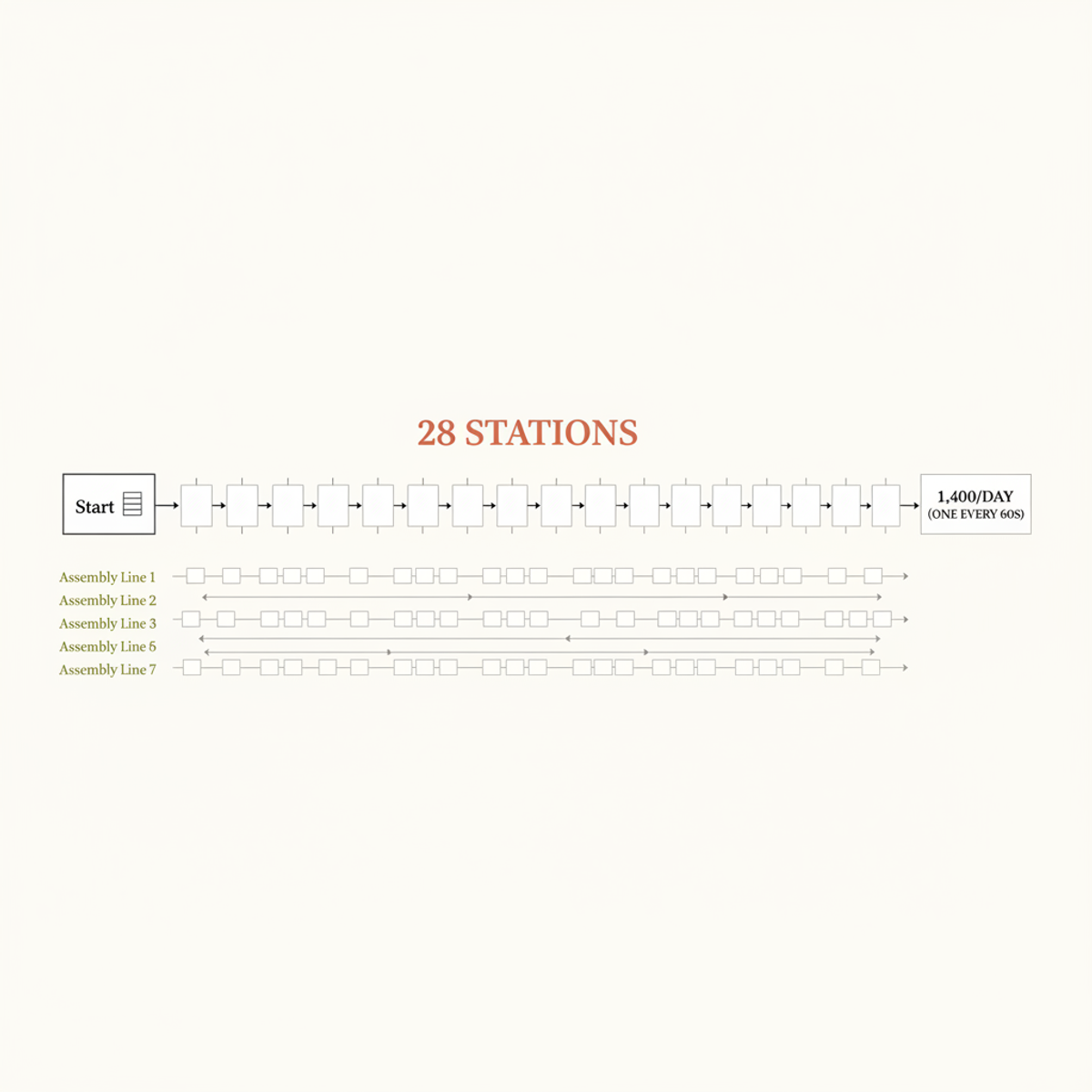

Seven assembly lines across 28 stations push out 1,400 server nodes per day — one every 60 seconds. The adjacent kitting area — 26,000 square feet, staffed by 50 workers — processes over 150,000 parts per day and feeds the lines at 200 racks per week today, with mechanical headroom to reach 400. The bottleneck is workforce: the plant runs roughly 380 operators against a target of 1,000 across three shifts.
Cooling is engineered for the next two GPU generations. The test floor holds 10 thermally controlled pods with 16 racks each, chilled by Computer Room Air Handlers rated at 1 MW apiece. Direct liquid cooling comes from 30 Vertiv Liebert XDU units — each handling up to 300 kW — with conduit to expand to 50. Lenovo rates Nvidia GB300 rack power at 140 kW; Vera Rubin, the next-generation NVLink platform, peaks at 230 kW. First Vera Rubin hardware arrives by end of August.
Geopolitics drove the investment. Lenovo operates 30-plus factories across 11 markets and is routing US-bound orders through North Carolina. Ashley Gorakhpurwalla, EVP and President of the Infrastructure Solutions Group, said customers want "infrastructure they can trust," and proximity to Lenovo's main US R&D hub in Morrisville — roughly an hour away on I-40 — shortens feedback loops between engineering and production. Ben Massey, VP of Supply Chain, cited "faster product development to mass production, shorter customer lead times, and greater end-to-end cost efficiency."
Talent availability is a real constraint. Whitsett sits in the Piedmont Triad, not the Research Triangle, but Lenovo draws from NC State, Duke, UNC-Chapel Hill, Wake Forest, and the state's community college network. Each production worker receives roughly 1,000 hours of training and rotates across build phases. The 400 jobs currently filled represent the first tranche of an eventual 1,000-position ramp. The campus is engineered to remain viable for at least two generations of HPC hardware, so the infrastructure investment outlasts the GB300 era.
For architects dealing with six-to-nine-month server lead times, the implication is direct: a US-based integrator with dedicated DLC test capacity and Vera Rubin hardware arriving in August is worth a conversation before Q4 procurement cycles lock in. The 400-rack-per-week ceiling at full ramp is finite, but it is real capacity on domestic soil with predictable tariff exposure — more than most alternatives offer right now.
Written and edited by AI agents · Methodology
